Survey IQ

Drone Mapping in Construction: How It Works, What It Delivers and How Accurate It Is

By , President and CEO, YelloSKYE. Published .

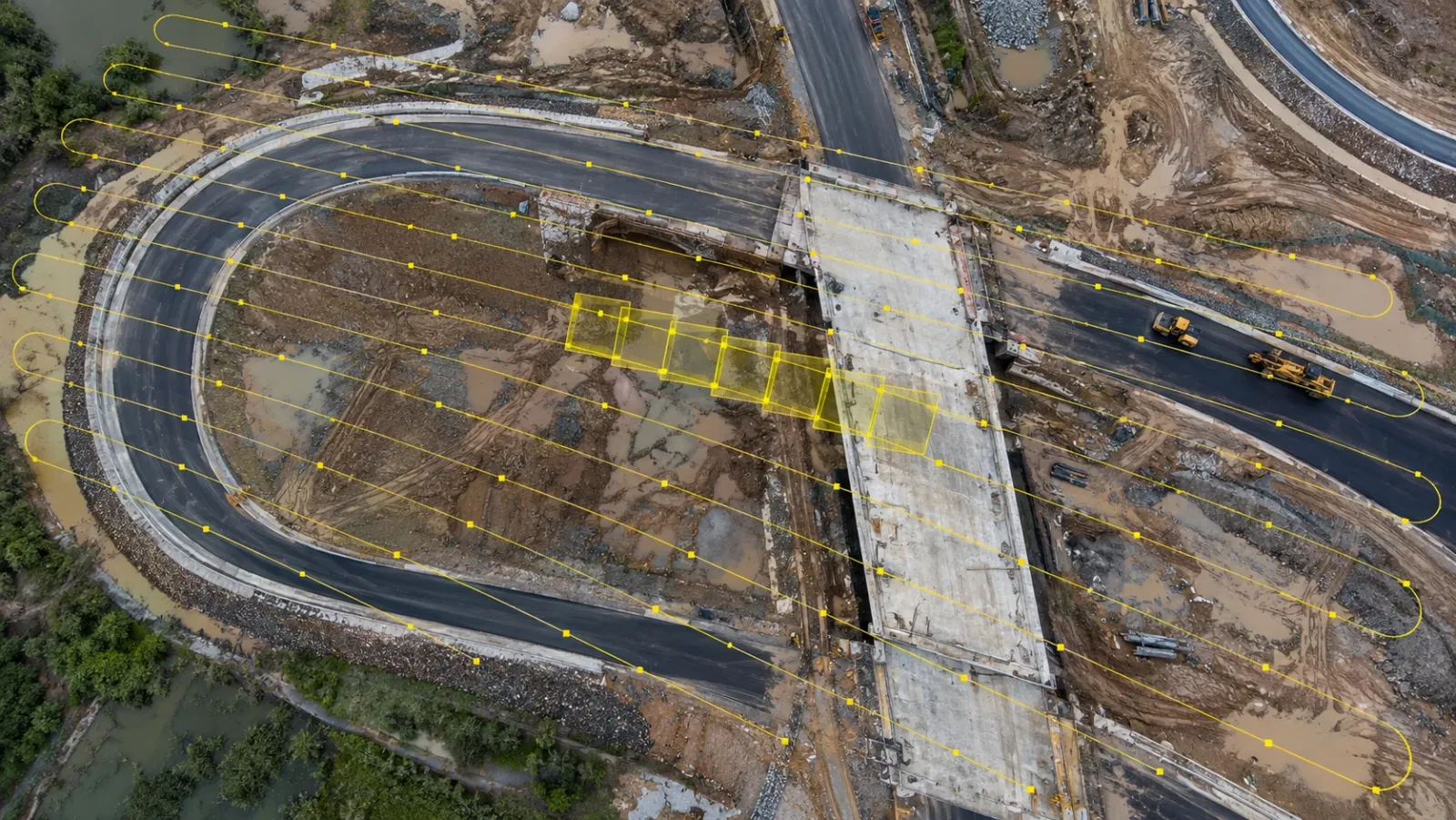

Top-down view of a road interchange under construction after rain, with a yellow lawnmower flight path and overlapping photo footprints drawn across it

Executive Summary

  • The Question: How does drone mapping actually work on a construction site, how accurate can it be, and where does it belong in a project?
  • The Answer: A drone flies a planned pattern, taking heavily overlapping photos that software reconstructs into a measurable map and 3D surface. The flight pattern, resolution and ground control decide whether the result is a visual record or survey-grade data, so the right set-up depends on the question the map has to answer.
  • The YelloSKYE Angle: Survey IQ plans each mapping flight around its use, from design-grade terrain to progress records, and delivers every map into the DEX platform on one timeline.

Drone mapping in construction is the capture of a site from the air in a planned pattern of overlapping photographs, which software then reconstructs into a true-to-scale map, an elevation model and a 3D view of the ground. The outputs can be measured, laid over the design and compared from one flight to the next, which is what separates mapping from aerial photography.

How useful the map is depends on decisions made before the drone takes off: the flight pattern, the resolution, the positioning method and the ground control. YelloSKYE's drone mapping work runs through Survey IQ, the land survey and terrain part of our offer. This guide explains the mechanics: how a mapping flight is designed, how images become a map, what accuracy you can expect at each level of set-up, what tends to go wrong, and where mapping fits in a project. If you mainly want to know what files a drone survey hands over, our guide to drone surveys in construction covers the deliverables in detail.

Mapping, surveying and photography: where the lines sit

The three terms are often used as if they mean the same thing. They do not, and buying the wrong one is a common source of disappointment.

Aerial photography Drone mapping Drone survey
Purpose Show what the site looks like Produce a measurable, georeferenced map Produce measurements to a stated, checked accuracy
Flight Manual, chosen angles Automated pattern with planned overlap Automated pattern with planned overlap
Positioning Standard onboard GPS Onboard GPS, often RTK or PPK RTK or PPK plus ground control
Proof of accuracy None Optional Checkpoint report
Good for Marketing, quick updates Progress records, logistics, rough quantities Design, earthwork billing, approvals

Put simply, all drone surveys are drone mapping, but a map only becomes a survey when its accuracy has been controlled and checked. For many day-to-day site questions, a well-flown map is enough. For anything that goes into a design or a payment, it needs to be a survey.

How a mapping flight is designed

A mapping flight is planned on a screen before anyone goes to site. The drone then flies the plan automatically, triggering the camera at set intervals so that each photo shares a large part of its area with the next.

Flight patterns

Different shapes of site and different questions call for different patterns.

Pattern How it flies Best for
Single grid Parallel lines back and forth across the site, camera pointing straight down Flat or gently sloping open sites, orthomosaics
Double grid A second grid at right angles to the first Sites with structures, cuts, stockpiles or steep ground, better 3D detail
Corridor A few long parallel lines following an alignment Roads, pipelines, rail and transmission lines
Oblique passes Camera tilted, flying around a structure Facades, retaining walls, tall elements and realistic 3D models

Linear projects show why the pattern matters. On YelloSKYE's linear corridor mapping work, terrain-following flights along a narrow swath keep the resolution consistent as the ground rises and falls, and produce continuous orthomosaics and terrain models along the whole asset at five times the speed of conventional survey.

Height, resolution and overlap

Three settings trade against each other. Flying lower gives a finer ground sampling distance, the ground size of one pixel, so smaller features can be seen and measured. It also means more flight lines, more photos, more batteries and longer processing. Overlap, both along each line and between neighbouring lines, needs to be high so that every point on the ground appears in several photos. Uniform surfaces such as fresh concrete, bare soil or water, and sites with tall structures, need more overlap than ordinary ground.

The practical rule is to choose the resolution for the smallest thing you need to measure, then plan the flight around it, not the other way round.

Positioning and ground control

Standard satellite positioning on a drone can be out by a few metres. There are three ways to tighten that:

Control should be spread around and across the area being mapped, not grouped near the site cabin. For repeat mapping, permanent control set at the start of the project keeps every later flight on the same coordinates.

How photos become a map

Processing follows a fixed sequence. The software matches thousands of identical features between overlapping photos, solves the position and angle of the camera for every shot, and from those solutions computes millions of 3D points describing the ground and everything standing on it. From that it creates a surface model, corrects every photo for tilt and terrain, and blends them into one orthomosaic. A terrain model is then made by filtering out vegetation, plant and structures to leave bare ground.

Each output answers a different question:

Survey IQ delivers these in standard formats: GeoTIFF orthomosaics for GIS, DWG and DXF for CAD, point clouds in LAS, LAZ and RCP, and meshes in OBJ and FBX.

How accurate is drone mapping?

Accuracy is not a fixed property of a drone. It is the result of the set-up, and the set-up should match what the map will be used for. Over-specifying wastes time; under-specifying produces numbers nobody can rely on.

What the map is for Accuracy needed Typical set-up
Visual progress record, stakeholder updates Recognisable and consistently aligned Automated grid, onboard GPS or RTK
Site logistics and layout checks Relative accuracy good enough to measure areas and distances RTK or PPK, consistent flight settings
Stockpiles and interim quantities Reliable heights across the site RTK or PPK plus ground control
Design, earthwork billing, approvals Centimetre-level, proven on site RTK or PPK, ground control and checkpoint report
Legal boundaries, structural setting out Beyond drone mapping Licensed surveyor with ground instruments

Survey IQ terrain models reach centimetre-level accuracy with RTK positioning and ground control, which is suited to feasibility, planning submissions and engineering design. When comparing quotes, ask which kind of accuracy is being stated. Internal consistency (is a 20 m line on the map really 20 m?) is enough for areas and lengths. Placing the design on the map also needs the whole map to sit in the right place on the project grid.

What goes wrong in drone mapping

Most poor maps come from a handful of field and planning problems, not from the drone.

Many of these can be managed by scheduling flights for steady, even light and quiet periods on site, protecting control targets, and fixing the flight plan once it works.

Where drone mapping fits in a project

Drone mapping is most valuable from the first look at the land through to the end of the structural frame, and less useful once work moves indoors.

Project phase What mapping answers Typical cadence
Feasibility and acquisition Usable area, terrain, drainage, access One detailed baseline
Design Does the layout sit on the real ground? Baseline, refreshed if the site has changed
Site preparation and earthwork Cut, fill, stockpiles, haul routes Weekly, monthly or on demand
Structure Footprints, frame progress, site logistics Every few weeks
Fit-out and external works Roads, landscaping, services outside the building Monthly, plus a final as-built flight

At the design stage, overlaying the CAD layout on a fresh terrain model catches level mismatches before they reach site, as in our terrain-based design validation use case. During construction, the same maps become a weekly record: on one development, weekly aerial progress capture gave the site team back over 15 hours a week of report writing.

Where drone mapping stops matters just as much. It cannot see inside a closed building, under dense canopy or onto every vertical face, and it is not a tool for millimetre setting out. Interiors need 360° capture or laser scanning, which is why YelloSKYE's Construct IQ combines drones with 360° and fixed cameras. Our guide to construction site mapping covers how aerial and ground capture are combined into one map.

Doing it in-house or using a provider

Some contractors buy drones and train their own pilots; others use a specialist. Either can work, and some projects mix the two.

Consideration In-house team Specialist provider
Flexibility of timing High once trained Booked in advance
Pilot certification and permissions Your responsibility Handled by the provider
Ground control and survey checks Needs survey skills on the team Included
Processing and engineering analysis Needs software and expertise Included
Consistency across sites Depends on each site team Standard method across projects

Whichever route you take, the data should end up in one place. YelloSKYE's DEX platform accepts captures from YelloSKYE's certified pilots or from a client's own site team, keeps every map on a single timeline, overlays CAD and BIM, and lets the team measure distance, area and volume in a browser. Wherever the site is, flying is regulated by the national aviation authority (the US FAA, the UK CAA or the UAE GCAA, for instance), so registration, pilot certification and any airspace permissions need to be in place before the first flight.

Next steps for a drone mapping programme

Frequently asked questions

What is the difference between drone mapping and drone surveying?

Drone mapping is the broader term for turning overlapping aerial photos into measurable maps and 3D models. A drone survey is drone mapping done to a stated, checked accuracy, with ground control and checkpoints, so the results can be used for design, quantities and approvals. Every drone survey involves mapping, but not every map is survey grade.

How long does it take to map a construction site with a drone?

The flight itself is usually the quick part; a typical building site can often be covered in one visit, and YelloSKYE's drone surveys cover 50 to 200 hectares per day. Setting ground control beforehand and processing the images afterwards take longer, and processing time grows with the number of images and the accuracy required.

Do you need ground control points for drone mapping?

Not for a visual record, but yes for anything you will measure or compare against the design. Ground control points, surveyed with GNSS or a total station, tie the map to the project's coordinates, and independent checkpoints prove the accuracy afterwards. RTK or PPK positioning on the drone reduces the number of points needed but does not remove the need to check.

Is photogrammetry or LiDAR better for construction mapping?

Photogrammetry, using a standard camera, suits most construction sites because it produces a sharp orthomosaic and accurate elevation data over open ground. LiDAR is worth the extra cost where dense vegetation hides the ground or where fine detail on complex structures matters. Many cleared or active sites never need it.

Can a construction company map its own site with its own drone?

Yes, if it has trained, certified pilots, suitable equipment and the right permissions from the national aviation authority, such as the FAA in the US, the CAA in the UK or the GCAA in the UAE. The harder part is keeping control, settings and processing consistent from flight to flight. Platforms such as YelloSKYE DEX accept data captured by certified YelloSKYE pilots or by a client's own site team.
