Pre-Pour Inspection Checklist: What to Verify Before Concrete Is Placed

A pre-pour inspection checklist for formwork, reinforcement, cover, embeds and sleeves, with the timing and capture that let you fix problems before concrete.

Kush Agarwal

Kush Agarwal · President and CEO, YelloSKYE

Updated 9 min read

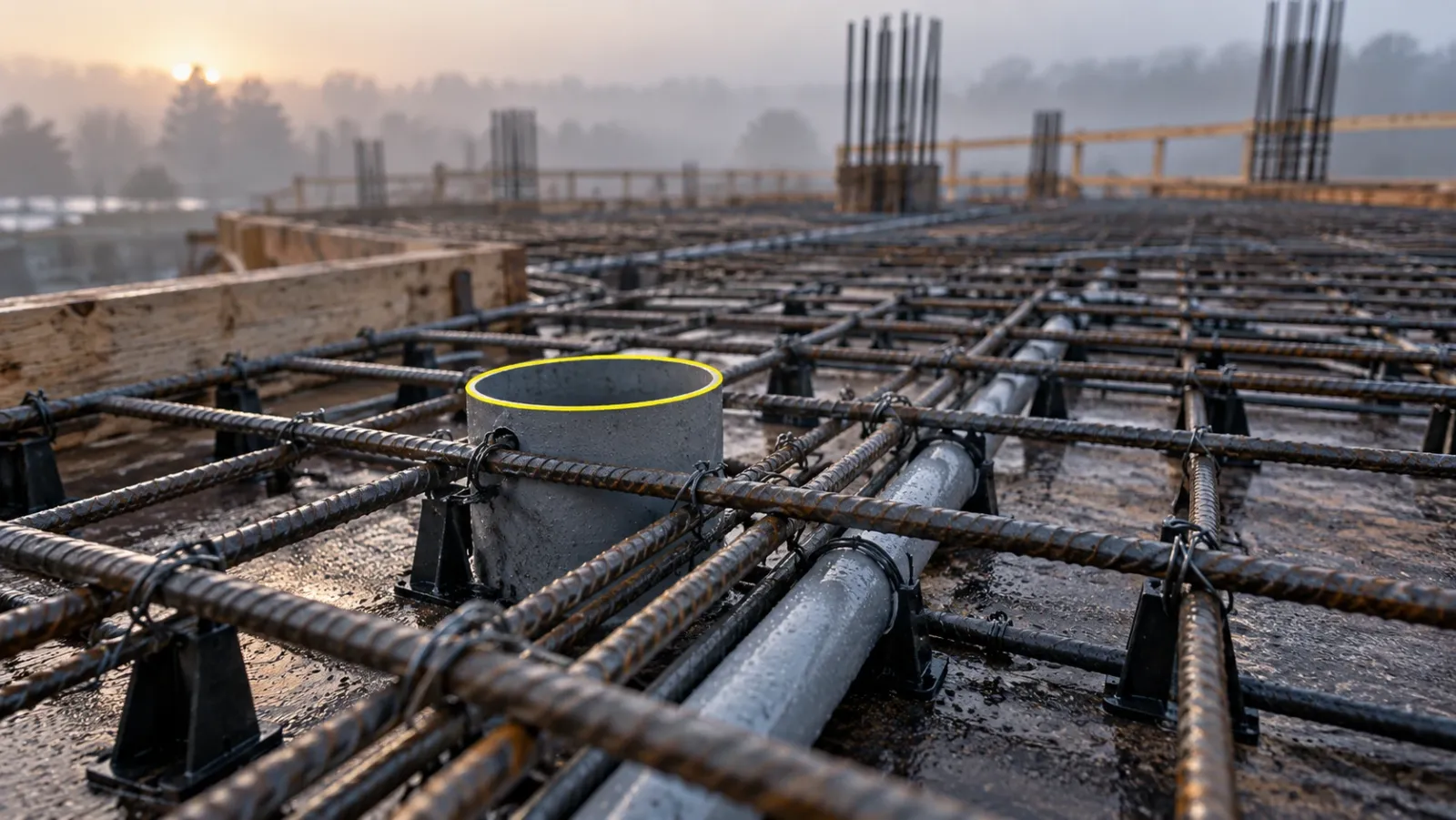

Close-up of a tied reinforcement mat on a concrete deck at misty dawn, with a pipe sleeve and conduit passing through the bars and one sleeve ringed in yellow

Key takeaways

  • The Question: What should be checked before a concrete pour, and when should it be captured so that problems can still be fixed?
  • The Answer: Check formwork, reinforcement, cover, cast-in items, services and readiness against the drawings, early enough to correct what is wrong. Record the whole element before release, because once the concrete is placed the only evidence of what is inside it is what you captured beforehand.
  • The YelloSKYE Angle: Construct IQ captures decks by drone and 360° camera ahead of pours, and BIM IQ laser scans compare placed elements with the design model where tolerances are tight.

A pre-pour inspection checks everything that will end up inside or against a concrete element before the concrete arrives: formwork, reinforcement, cover, sleeves, embeds, conduits and drains. It ends with a pour release, a signed decision that the element is ready. Because hardened concrete cannot be adjusted, this is one of the few inspections on site where a missed item is almost always expensive.

This guide gives a checklist you can adapt to slabs, walls, columns and foundations, explains how to time the inspection so corrections fit before the pour, and shows how to capture the deck so the record is useful long after it is buried. We approach this through Construct IQ, combining aerial, 360° and laser scan capture of the structure as it rises.

Why the pour is the hardest deadline on site

Most construction work can be adjusted after the fact, at a cost. A misplaced partition can be moved; a wrong light fitting can be swapped. Concrete is different. Once it is placed and begins to set, the reinforcement, sleeves and embeds inside it are fixed for the life of the structure.

That changes what a mistake costs. A sleeve left out of a slab means coring through it later, which usually requires the structural engineer to approve the location, a scan to avoid cutting reinforcement or post-tensioning tendons, and the coring crew's time. A cast-in plate in the wrong place means a post-fixed alternative that may need its own design. Low cover means repair work and a durability question that may never fully go away. Each of these also delays the trades waiting to work in that area. Our guide to the cost of rework in construction looks at how these costs add up across a project.

The pour itself also sets the pace. Concrete deliveries, pumps and finishing crews are booked days ahead and are costly to cancel. That creates pressure to release a deck that is nearly ready. A clear checklist and a planned inspection time take that pressure out of the decision.

Who is involved in the pour release

PartyWhat they confirm
Structural engineer or representativeReinforcement, cover and any changes to openings agreed
Formwork contractorFormwork and falsework are complete, stable and to line and level
Reinforcement contractorBars are fixed as detailed and spacers are in place
Mechanical, electrical and plumbing tradesTheir sleeves, conduits, drains and boxes are positioned and secured
Concrete contractorMix, pump, access, finishing crew and curing method are ready
Quality lead or site engineerAll checks are recorded and the release is issued
Building authority, where requiredStatutory inspection completed; requirements vary by jurisdiction

A single named person should issue the release. When several people each assume someone else has checked the services, sleeves get missed.

The pre-pour inspection checklist

Group the checks by what they protect. The tables below suit a typical suspended slab; adapt them for walls, columns and foundations.

Formwork and falsework

CheckWhat good looks likeEvidence
DimensionsEdge of slab, openings and steps match the drawingMeasured offsets from gridlines
Line, level and camberWithin the specified tolerance, with camber where designedLevel readings
FalseworkProps, bracing and loading as per the temporary works designTemporary works sign-off
Joints and sealsTight enough to stop grout lossPhoto of edges and joints
Release agentApplied evenly, not on the reinforcementVisual check
Edge protection and accessIn place for the pour crewSafety check record

Reinforcement and cover

CheckWhat good looks likeEvidence
Bar size and spacingAs shown on the bending schedule and drawingsTape in frame against bars
Laps and anchorageLengths and positions as detailedMeasured laps at sample points
Additional barsTrimmer bars at openings, shear links and punching reinforcement presentPhoto of each opening
CoverSpacers and chairs at the specified height and spacing, none crushedCover meter or gauge at sample points
FixingBars tied and stable enough to walk on during the pourVisual check
Starter barsPositioned for the walls and columns aboveMeasured offsets from gridlines

Cast-in items and services

CheckWhat good looks likeEvidence
SleevesEvery sleeve on the coordinated drawing present, at the right size and positionDeck image overlaid on the sleeve drawing
Blockouts and recessesFormed to size and fixed so they will not floatPhoto and dimensions
Embeds and anchor boltsPlates, channels and bolt groups at position and level, with templates where usedMeasured positions
Conduits and floor boxesRouted and fixed, ends sealed, boxes at finished floor levelPhoto of runs and boxes
Floor drains and gulliesPositioned to falls, protected from concretePhoto and levels
Earthing and lightning protectionConnections made where specifiedPhoto and test where needed

Joints, cleanliness and readiness

CheckWhat good looks likeEvidence
Construction jointsAt agreed locations, prepared and with any waterstop fixedPhoto of each joint
CleanlinessNo tie wire, timber, debris or standing water in the formsVisual check before release
WeatherPlan in place for heat, cold, wind or rain during placing and curingPour plan
TestingSamples and test regime arrangedTest schedule
LogisticsPump position, truck access, finishing crew and lighting confirmedPour plan

Not every item needs a photograph, but every item needs a recorded result. The ones marked with measured evidence are those most likely to be questioned later.

Timing the inspection so fixes are possible

The most common reason a pre-pour check fails is not that nobody looked. It is that someone looked too late to act. If the first proper inspection happens an hour before the trucks arrive, a missing sleeve gets noted rather than fixed.

A practical rhythm for a suspended slab looks like this:

  1. During fixing. As the bottom mat and services go in, the services trades check their own items against the coordinated drawing. This is when a missing sleeve is cheapest to add.
  2. Main inspection, the working day before. The full checklist is completed, the deck is captured, and any defects are listed with owners.
  3. Correction window. Trades fix the listed items the same afternoon. Each fix is re-photographed.
  4. Final walk on the morning. A short check that nothing has been displaced by foot traffic or weather, and the release is issued.

Large or complex decks may need the main inspection earlier still. The rule is simple: leave enough time between finding a problem and the first truck to fix the problem.

Capturing the deck before the pour

The capture has two jobs. It helps the inspection by making the whole deck reviewable at once, and it becomes the permanent record of what is inside the slab.

MethodWhat it shows wellLimits
Drone flight over the open deckThe full slab in one measurable image; positions of sleeves, blockouts and edges against the drawingCannot see under the top mat or read bar sizes
360° walk on the deckEvery bay in context, plus soffit and edge details from below where accessibleLess suited to precise measurement
Terrestrial laser scanPrecise positions of embeds, bolt groups and openings for comparison with the design modelTakes longer to set up and process
Phone photos with a tapeBar sizes, laps, cover and labels close upHard to locate later without a plan

On an open site, a drone flown low over the deck gives the best overall view. YelloSKYE flies RTK-GNSS drones tied to surveyed control points, which keeps positions to ±2–3 cm, enough to spot a missing or badly misplaced sleeve. Where tolerances are tighter, such as bolt groups for steel or precast connections, a laser scan is the right tool. In our as-built versus BIM clash detection use case, terrestrial scans are overlaid on the Revit or Navisworks model so that a missing duct sleeve or misplaced element is found before the next stage starts.

Whatever the method, compare the capture with the coordinated drawing rather than the structural drawing alone. Sleeves and embeds come from the services and architectural design, and it is the coordinated set that shows all of them together. DEX overlays CAD and BIM models on site captures so a reviewer can see each expected sleeve and whether it is there.

Flying over a tower deck or close to occupied neighbours is regulated, and the rules change from country to country. Confirm what your national aviation authority allows before planning flights; the FAA, the UK CAA and the UAE GCAA are examples of such regulators.

After the pour: keep the record useful

The pre-pour capture stays valuable for the life of the building. When a future fit-out needs to core a slab or fix into it, the image shows where the conduits, sleeves and reinforcement lie, which reduces the scanning and trial holes needed. Keep it filed against the level, pour number and gridlines, and add a short post-pour survey of slab levels and opening positions so the record shows what was actually achieved.

The same thinking applies to every element that will later be hidden. Our pre-drywall inspection guide covers the equivalent check before walls and ceilings close, and construction quality control explains how hold points like this fit into a wider inspection plan. If you are capturing structural progress on a regular cycle anyway, as in our aerial progress capture work, time one flight just before each major pour so the deck is recorded without a separate visit.

Why pre-pour checks miss things

  • The services drawing is out of date. The trade checks against an old revision and the sleeve for a late change is missing.
  • Nobody owns the services check. Reinforcement is inspected carefully, but cast-in items fall between the structural engineer and the services trades.
  • Inspection is too close to the pour. Problems are found but there is no time to fix them.
  • Displacement after inspection. Sleeves and boxes knocked by foot traffic or the pump line between inspection and placing.
  • No record of the passed condition. Defects are photographed, but the correct deck is not, so there is nothing to show later.

Before you release the pour

Run through these points with the person issuing the release:

  1. Is the coordinated drawing set current, and did every trade check against it?
  2. Has the structural engineer accepted the reinforcement and cover?
  3. Is every sleeve, embed, box and drain on the drawing confirmed on the deck?
  4. Have all defects from the main inspection been fixed and re-captured?
  5. Is the whole deck captured, by drone, 360° camera or scan, and filed against the pour number?
  6. Have the formwork, falsework and edge protection been signed off?
  7. Are the mix, pump, finishing crew, weather plan and testing confirmed?
  8. Has one named person issued the release in writing?

If any answer is no, the pour waits. A delayed pour costs a day. A missed sleeve can cost far more, and it stays in the building.

Frequently asked questions

What is a pre-pour inspection?

A pre-pour inspection is the check of formwork, reinforcement, cast-in items and services carried out before concrete is placed. It confirms the element matches the structural and coordinated services drawings, and it ends with a formal release that allows the pour to go ahead. Once concrete is placed, anything missed can only be fixed by cutting, drilling or breaking out.

How long before a pour should the inspection happen?

Early enough that corrections can be made without moving the pour date. Many teams hold the main inspection one working day before the pour and a short final walk on the morning itself to check nothing has been disturbed. On large decks with many cast-in items, an earlier interim check while the reinforcement is going in is worth adding.

Who signs off a pour?

The contractor's engineer or quality lead normally issues the pour release, after the structural engineer or their representative has accepted the reinforcement and each services trade has confirmed its cast-in items. Some contracts and jurisdictions also require a building authority inspection. Check your specification and local rules for who must sign.

Why is concrete cover checked before the pour?

Cover is the depth of concrete between the reinforcement and the surface, and it protects the steel from corrosion and fire. If spacers are missing or have been crushed, cover can be too thin, which shortens the life of the structure. It cannot be corrected after the pour without major repair, so it is measured beforehand.

Can a drone inspect a deck before the pour?

A drone flown low over an open deck produces a measurable image of the whole slab, which is useful for checking the positions of sleeves, blockouts and embeds against the coordinated drawing. It does not replace a close inspection of bar sizes, laps and cover, which still needs someone on the deck. Many teams use the drone image for layout and a person or laser scan for detail.

Put this into practice

Eliminate blind spots with Construct IQ.

Keep reading

All guides
Construct IQSee it on your siteBook a demo
Book Your Free Demo

Ready to gain
absolute clarity?

Request a custom walkthrough of your site and see how YelloSKYE delivers boardroom-ready answers.

  • 15-Minute Walkthrough
  • Zero Commitment
  • Custom Strategy

Providing intelligence to intelligent leaders

Larsen & Toubro
Amazon
TATA Projects
Adani Enterprise
DLF Limited
Google
Godrej
Lodha
HDFC
Kirloskar
Toyota Kirloskar
Mahindra
Larsen & Toubro
Amazon
TATA Projects
Adani Enterprise
DLF Limited
Google
Godrej
Lodha
HDFC
Kirloskar
Toyota Kirloskar
Mahindra
