Inspect IQ

Drone Roof Inspection for Commercial and Industrial Buildings

What a drone roof inspection finds on commercial and industrial roofs, how the survey is planned and delivered, and how the findings become a repair plan.

Kush Agarwal

Kush Agarwal · President and CEO, YelloSKYE

10 min read

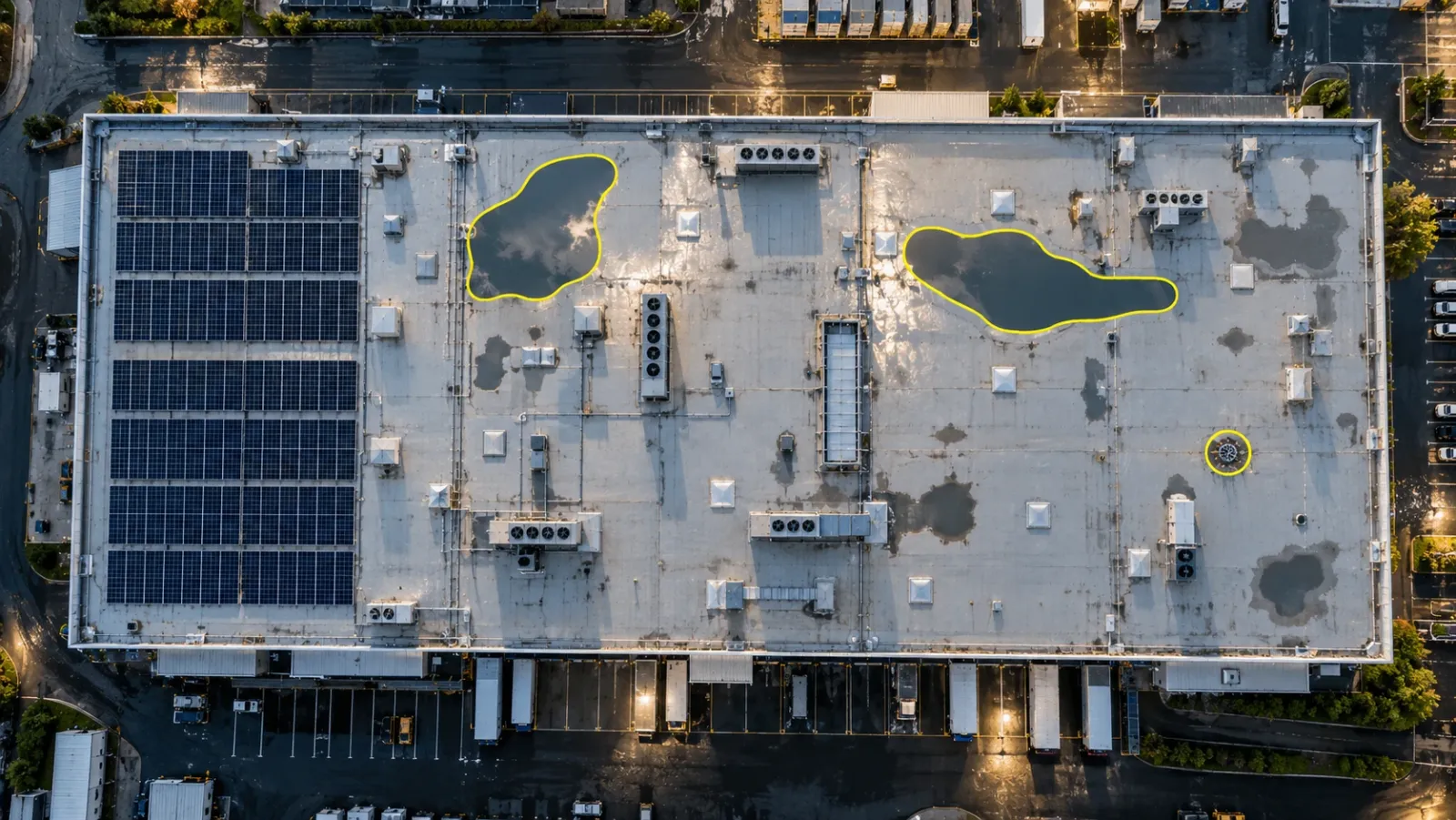

Top-down drone view of a large warehouse flat roof just after rain, with yellow outlines around two areas of ponding water and a circle around one roof drain

Key takeaways

  • The Question: What can a drone roof inspection find on a commercial or industrial roof, and how do those findings turn into a repair plan?
  • The Answer: A drone records the whole roof in one visit: ponding, torn or blistered membrane, open seams, blocked outlets, loose flashings and solar array faults, with a thermal pass for wet insulation. The result is a located, measured defect list that a roofing contractor can price and a facility manager can schedule, so people only go up where a hands-on check is needed.
  • The YelloSKYE Angle: Inspect IQ captures roofs with RGB and thermal sensors while the building keeps running, and DEX keeps every roof survey on one timeline so each defect can be tracked until it is closed.

A drone roof inspection is a survey of a roof from the air, using high-resolution photographs and usually a thermal camera, to record its condition without anyone walking on it. On a large commercial or industrial roof it replaces a slow walk-over, or scaffolds and crawling boards on fragile roofs, with a complete and measurable record of the whole surface.

YelloSKYE carries out roof surveys through Inspect IQ, deploying RGB and thermal sensors over commercial facilities to locate water pooling, membrane tears and failing solar cells before they lead to leaks. This guide treats the roof as an asset to be managed. It covers what goes wrong on flat and metal roofs, how a survey is planned, what you should receive, how findings become a repair programme, and where a person still has to go up. How thermography works, and when its readings can be trusted, is explained in our guide to drone thermal inspection.

Why inspect a roof from the air

Large roofs are hard to inspect well on foot. A distribution warehouse or factory roof can cover several football pitches, and an inspector walking it sees a strip a few metres wide at a time. Coverage is patchy, and findings are recorded as notes and photos that are hard to place afterwards.

Walking a roof also carries risk and causes wear. Fragile rooflights and older fibre cement sheets are a known fall hazard, and foot traffic itself scuffs membranes and loosens laps. Meanwhile the building below usually has to keep working.

A drone survey changes the economics:

  • Complete coverage. Every square metre is photographed, including areas nobody would walk to.
  • A plan view that matches the drawings. The roof map can be read against the roof plan, plant layout and drainage design.
  • No interruption. Inspect IQ captures data while the asset stays fully operational.
  • A record you can compare. Each survey sits in the same coordinates as the last one, so change is visible.

In the automated asset inspection use case, replacing scaffolding and rope access with drone capture made inspections 10x faster.

What a drone roof inspection finds

Most roof leaks start at a small number of weak points: joints, junctions, outlets and anything that pierces the membrane. A survey is built around finding them.

DefectHow it looks from the airBest sensorWhy it matters
Ponding waterStanding water, or dirt rings and algae marking where water satRGB, ideally soon after rainAdds load, ages the membrane faster and signals poor falls or blocked outlets
Membrane tears and puncturesCuts, holes and scuffs, often near plant and access routesClose RGBDirect path for water
Failed seams and lapsLifted edges, open laps, wrinkles along seam linesOblique RGB, thermal nearbyA frequent leak path on single-ply and bitumen roofs
Blistering and ridgingRaised bubbles or lines in the surfaceRGB with low-angle lightTrapped air or moisture that can split the surface
Flashing and upstand defectsDetached or cracked flashing at parapets, plant kerbs, rooflights and pipesOblique RGBJunctions are where roofs most often leak
Blocked drains and guttersDebris, silt or plants around outlets, overflow stainingRGBLeads to ponding and water overtopping into the building
Metal roof faultsCorrosion at laps and cut edges, missing fasteners, displaced sheetsRGBLeaks and wind damage
Rooflight damageCracked, crazed or discoloured rooflightsRGBLeak risk and a fall hazard
Wet insulationWarm areas after sunset on a low-slope roofThermalHidden, spreads over time and drives repair scope
Solar array defectsCracked glass, soiling, hot cells, displaced ballast, damaged cablesRGB and thermalLost output, and faulty connections can overheat

Low-slope membrane roofs

Single-ply, built-up and modified bitumen roofs depend on continuous waterproofing and on water reaching the outlets. Ponding, open seams and damaged upstands are the main findings. Because the membrane sits over insulation, a puncture can let water spread a long way under the surface before anything shows inside. A thermal pass is what reveals that hidden spread.

Metal and profiled sheet roofs

Profiled metal roofs fail differently. The usual issues are corrosion at cut edges and side laps, fasteners that have backed out or rusted, sealant that has perished at end laps and ridge, and gutters that hold water. Oblique imagery along the laps and gutters matters more here than a thermal survey.

Roofs carrying solar panels

Rooftop solar adds both an asset and a blind spot. The panels need their own checks for hot cells, string faults, soiling and damaged cables, which follow the same thermal signatures used in YelloSKYE's solar farm thermal inspection work. The roof under the array also needs attention: mounting penetrations, ballast that has shifted, and cable routes that cross the membrane. Surveying both in one visit avoids paying twice for access and coordination.

Planning a drone roof survey

Start with the question and the records

Before any flight, collect what is already known: roof plans and build-up, previous inspection reports, warranty terms, and above all a log of interior leaks with their positions. Plotting leak locations onto the roof map later is one of the quickest ways to link a drip in the warehouse to a defect above it.

Permissions and coordination

Each country's national aviation authority (the FAA in the US, the UK's CAA and the UAE's GCAA are examples) sets the rules for commercial drone flights, and roofs close to airports or inside controlled airspace need clearance well ahead of the survey date. Tell the occupier when the flight will happen, agree a safe take-off area, and note any rooftop masts or equipment the pilot should keep clear of.

Timing

Different findings need different conditions, so a single visit is often split into passes:

  • Visible survey soon after rain shows ponding and drainage problems clearly, provided the surface has dried enough to read seams and laps.
  • Even daylight gives the best detail on membranes and flashings; low sun helps show blistering and ridging.
  • Thermal survey needs a dry roof and an evening flight after a clear, sunny day, as explained in the thermal inspection guide.

Flight plan

CaptureWhat it producesUsed for
Vertical grid of photosA true-to-scale map of the whole roofLocating, measuring and comparing defects
Oblique passes around the edgeViews of parapets, upstands, gutters and edgesFlashing and edge details
Close-up passesDetailed images of seams, outlets, penetrations and plant kerbsDiagnosing individual defects
Thermal gridA temperature map of the roof and any solar arrayMoisture extent and solar faults
3D modelRoof geometry, falls and plant positionsDrainage review and repair planning

The vertical grid is processed into an orthomosaic, a geometrically corrected map that can be measured; our guide to what an orthomosaic is explains how it is made.

What you should receive

A roof survey is only as useful as its deliverable. At minimum, expect:

  • a measurable map of the whole roof, with the thermal layer aligned to it;
  • a defect register in which each item has a location, an image, a description, a severity and a recommended action;
  • measured areas and lengths for the larger defects, such as ponding zones, wet insulation and failed seam runs;
  • the raw imagery, so a consultant or contractor can check any finding.

Inspect IQ reports list every defect with its coordinates, a marked-up image, a severity rating and suggested remediation, and can be exported as PDF or Excel or linked to a BIM model. In DEX, defects are tagged at their exact position on the captured roof, maintenance dashboards track open items and their severity across a portfolio of buildings, and the comparison view puts two survey dates side by side. The facade inspection from a desk use case shows the same habit applied to walls: measure the finding, compare dates, then decide whether access is needed.

Turning findings into a repair plan

A defect list running to hundreds of lines does not fix a roof. The step that matters is converting it into a programme of work that is priced, sequenced and checked.

Triage by consequence, not by count

Rank each finding by what it could cost if left: water entering above stock, production lines or electrical rooms comes first, followed by defects that will get worse with the next storm.

FindingTypical responseUrgency
Blocked outlet or gutterClear it and fit a guardImmediate, and cheap
Open seam or tear above a recorded leakPatch or re-weldBefore the next rain
Detached flashingRe-fix and sealBefore the next storm
Hot connector on a rooftop arrayElectrical repair by the solar maintenance teamPriority
Small area of wet insulationConfirm with cores, then cut out and replacePlanned repair
Widespread wet insulationAssess for overlay or replacementCapital planning
Persistent pondingAdd outlets or tapered insulation; ask an engineer to check for deflectionPlanned
Corroded laps on a metal roofTreat and seal, or replace sheetsPlanned

Measure before you price

Because the roof map is to scale, ponding areas, wet insulation zones and seam lengths can be measured and handed to contractors as quantities. Tenders become comparable, and fewer surprises appear once the roofer is on site.

Group work by trade and by zone

Sort the register into packages: membrane repairs, drainage maintenance, solar maintenance, plant-related fixes. Then plan one access visit per zone rather than sending each trade up separately.

Decide between repair and replacement on evidence

When wet insulation covers a large share of a roof, patching becomes poor value. A thermal map confirmed by a few cores gives the owner a defensible basis for a replacement budget, rather than a contractor's estimate alone.

Close the loop

After repairs, capture the repaired areas again from the same viewpoints and compare the dates. The before-and-after record shows the work was done, supports warranty and insurance conversations, and becomes the baseline for the next survey.

When someone still has to go up

A drone survey decides where and why people go onto the roof. It does not remove the need entirely.

  • Confirming wet insulation. Cores or moisture meters should verify thermal findings before large areas are cut out.
  • Probing seams. A seam can look closed from the air and still be unbonded; only a physical check finds that.
  • Fixings and uplift resistance. Fastener security, edge details and ballast need hands-on testing.
  • Hidden areas. Ground under solar panels, plant and walkways is partly or wholly out of the camera's view.
  • The underside. Deck condition and the actual drip points are inside the building.
  • Electrical testing. Suspected solar faults are confirmed with electrical tests.
  • Warranty inspections that the manufacturer requires to be attended in person.
  • The repairs themselves, with proper edge protection and access arrangements.

The difference is that the people who go up arrive with a marked position, a measured scope and an earlier image to compare against.

Roof inspection checklist

  • Gather roof plans, previous reports, warranty terms and a log of interior leak positions.
  • Confirm airspace permissions and notify the occupier.
  • Plan a visible pass soon after rain and a thermal pass on a dry evening after a sunny day.
  • Fly a vertical grid for the roof map, plus oblique and close-up passes for edges, outlets and penetrations.
  • Include any rooftop solar array and the membrane beneath it in the same visit.
  • Ask for a located, measured defect register with severity and recommended actions.
  • Rank findings by consequence, confirm the serious ones on site, and group work by trade and zone.
  • Re-capture repaired areas and keep every survey on one timeline for the next comparison.

Frequently asked questions

Can a drone inspect a commercial roof without anyone going on it?

For the survey itself, yes. A drone captures the whole roof from the air in high-resolution photographs, and usually a thermal pass as well, so the condition of every area is recorded without walking the surface. People still go up to confirm some findings and to carry out repairs, but they go to marked locations rather than searching the whole roof.

Can a drone find the source of a roof leak?

A drone survey shows the likely sources: open seams, tears, failed flashings, blocked outlets, ponding and, with a thermal camera, areas of wet insulation. Because water often travels along the deck before it drips inside, the leak path still needs confirming. Plotting known interior leak positions against the roof map narrows the search considerably.

Is a drone roof survey accurate enough to price repairs?

A controlled survey produces a true-to-scale map of the roof, so defect areas, membrane areas and run lengths can be measured on it and used to scope repairs. Contractors still check details such as build-up, deck condition and wet insulation depth on site before committing to a final price.

How often should a commercial roof be inspected?

Many owners survey commercial roofs at least once a year and again after severe weather, with drains and gutters checked more often. A baseline survey at purchase, handover or the start of a maintenance contract is worth adding, as is a check after any work on the roof, such as new plant or a solar installation.

Does a drone roof inspection disrupt building operations?

No. The drone flies above the roof, so the building can keep operating normally, and there is no need for scaffolding or foot traffic on fragile surfaces. The main coordination points are notifying the occupier, agreeing a safe take-off area and checking airspace permissions with the national aviation authority.
